Mumbai's western suburbs have long suffered a daily indignity: it takes anywhere from 45 to 90 minutes to travel the roughly 17 km between Versova and Bandra. The Versova-Bandra Sea Link (VBSL) — officially the Swatantrya Veer Savarkar Sea Link — is about to fix that. Once open, that same stretch takes under 15 minutes.
But the sea link isn't just a bridge. It's a series of connectors that determine exactly where you get on and off — and those connectors just got revised. Here's what you actually need to know.
The Four Connectors
The 9.6 km main bridge links up with four connector arms stretching the total project length to 17.17 km:
1. Bandra Connector (1.17 km, 2+2 lanes) Ties directly into the existing Bandra-Worli Sea Link. If you're coming from South Mumbai or Worli, this is your seamless entry point northward.
2. Carter Road / Otter's Club Connector (1.8 km, 3+3 lanes) Drops you at Carter Road in Bandra. Good news for anyone heading to the Bandra seafront or the BKC corridor.
3. Juhu Koliwada Connector (2.8 km, 2+2 lanes) Originally planned to terminate at Juhu Tara Road — now revised to Relief Road. The change is deliberate: better traffic dispersal, less bottlenecking into Juhu's already-congested streets.
4. Versova Connector (1.8 km, 3+3 lanes) Originally ending at Nana Nani Park — now revised to terminate at Juhu Circle, with a cable-stayed bridge connecting it directly to the Western Express Highway. If you're heading north toward Andheri or beyond, this is the exit that matters most.
Why the Revised Endpoints Matter
The Maharashtra Coastal Zone Management Authority (MCZMA) approved these revisions in August 2025. The MSRDC made the changes for two reasons: to reduce traffic congestion at the endpoints, and to address concerns from local fishing communities. The Juhu connector also gets a new 120-metre navigational span specifically to allow fishing vessels to pass underneath.
The Versova connector's new cable-stayed WEH link is particularly significant — it means VBSL users can flow directly onto the Western Express Highway without touching a single signal.

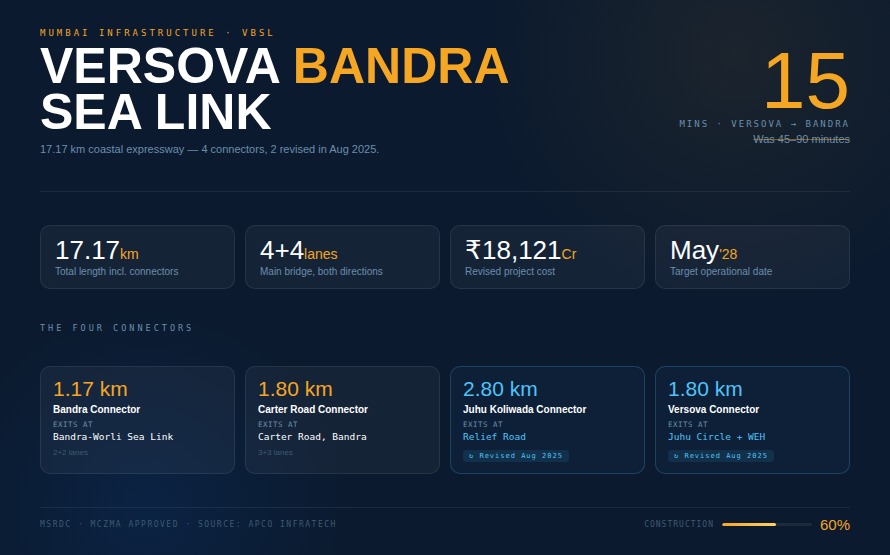

The Numbers
- Total length: 17.17 km (9.6 km main bridge + connectors)
- Lanes: 4+4 on the main bridge
- Travel time: Versova to Bandra in ~15 minutes vs. 45–90 minutes today
- Completion: Targeted operational by May 2028
The VBSL won't just cut your commute — it will fundamentally redistribute how western Mumbai moves. Andheri, Juhu, and Versova residents who currently grind through WEH or SV Road signals every morning will have a direct, uninterrupted coastal corridor to Bandra and beyond. That's the real story here.
